Buying Salesforce is only the starting point. The real work is making the platform fit your processes, data, teams and long-term goals.

A Salesforce implementation is the process of designing, configuring, integrating, and launching Salesforce so that it supports how an organisation works. It covers everything from validating the platform and planning the solution to data migration, testing, go-live and ongoing support.

A successful implementation is therefore more than a software installation. It is a business change programme involving people, processes, data, and technology. When these areas are planned together, Salesforce can provide a reliable foundation for daily work, trusted reporting, and future growth. Otherwise, the result may be duplication of effort, poor data quality, low user adoption, and a platform that becomes increasingly difficult to change.

This guide explains the Salesforce implementation process, the main Salesforce implementation steps, typical timelines and costs, and when a Salesforce implementation partner can add value.

The Salesforce implementation process – from validation to continuous improvement

A reliable Salesforce implementation process begins before configuration and continues after the platform goes live. The depth of each phase depends on the size and complexity of the project, but the underlying sequence remains similar.

The Salesforce implementation steps below cover platform validation, discovery, mobilisation, iterative delivery, data migration, testing, go-live, hypercare, and continuous improvement.

Step 0 – Validate the platform fit and business case

Before configuring Salesforce, confirm that it is the right platform for the problem the organisation needs to solve.

This phase reviews business goals, expected users, core processes, integration needs, and likely Salesforce products and licences. It should also consider whether the organisation is ready to change its current processes rather than simply recreate them in a new system.

For a focused implementation, this may be a short validation exercise. A larger programme may require stakeholder interviews, an initial architecture assessment, and a more detailed business case.

A strong implementation partner should be willing to explain when Salesforce is suitable, where compromises may be needed, and when another solution would be a better fit.

Typical participants: business sponsor, IT owner, industry specialist, and senior Salesforce architect.

Main outputs: a go/no-go decision, an initial scope, licence direction, key assumptions, and a high-level roadmap.

Step 1 – Discovery and the Salesforce implementation plan

Discovery turns the initial business case into a practical Salesforce implementation plan.

The team examines how people work today, where processes break down, and what the future experience should look like. The aim is not to copy every existing process into Salesforce. It is to decide what should be retained, simplified, automated, or redesigned.

Workshops usually cover user journeys, business rules, reporting needs, security, integrations, and data ownership. Early prototypes can help stakeholders respond to a proposed solution while changes are still easier and less expensive to make.

Discovery should also identify the main dependencies and delivery risks. This includes the systems Salesforce must connect to, the data that will move between them, the people responsible for key decisions, and the measures that will define success.

The level of detail depends on the project. A focused implementation may need one or two intensive workshops, while a larger programme may require several weeks of interviews, process mapping, and solution design.

Typical participants: business and IT process owners, business analysts, Salesforce architects, and representatives from the main user groups.

Main outputs: a prioritised backlog, solution outline, integration and data-flow view, delivery milestones, environment strategy, mitigated key risks, and agreed ownership.

Step 2 – Mobilisation, configuration, and development

Before the main build begins, the team needs to establish how changes will be developed, tested, and released.

This mobilisation stage may include version control, deployment pipelines, sandbox management, development standards, testing responsibilities, and release governance. These controls apply to both custom code and declarative changes, such as Flows, validation rules, and permission sets.

Once the foundations are ready, the team begins configuring and developing the solution in short iterations. Most Salesforce projects benefit from Agile delivery, with a manageable group of backlog items completed, demonstrated, and reviewed before the next iteration begins. This allows stakeholders to provide feedback while changes are still easier to make.

Standard Salesforce capabilities should be used when they meet business needs. Apex code and Lightning components are appropriate when configuration alone cannot deliver the required functionality, performance, or user experience.

Testing, security checks, and documentation should form part of every iteration. Without consistent delivery controls, teams may struggle to understand how changes affect one another, increasing release risk and contributing to Salesforce technical debt.

Typical participants: a delivery lead, Salesforce architects, developers, administrators, business analysts, testers, and business representatives.

Main outputs: configured delivery environments, tested and documented functionality, stakeholder feedback, updated backlog priorities, and features ready for release.

Step 3 – Salesforce data migration, UAT, and go-live

As the solution approaches completion, the focus shifts to data, end-to-end testing, and launch preparation.

A successful Salesforce data migration starts with deciding what information should be moved, where it comes from, and how it will be cleaned. Migrating every historical record is rarely necessary. The priority should be reliable data that supports daily work, reporting, automation, and compliance requirements.

The team should test configuration, custom code, integrations, permissions, and complete business processes. UAT then gives representative users an opportunity to confirm that the solution works in realistic scenarios and meets the agreed acceptance criteria. Issues should be prioritised and resolved before deployment rather than transferred into the production backlog.

Preparing for Salesforce go-live also requires a clear cutover plan. It should define the deployment sequence, data-freeze period, responsibilities, user communications, final checks, and rollback plan. Training and support materials should be ready before users receive access.

For complex implementations, a phased launch can reduce risk and provide useful feedback before a wider rollout. Release readiness should also consider relevant Salesforce platform updates and confirm that integrations, permissions, and support channels are ready for production.

Typical participants: delivery lead, Salesforce architects, migration specialists, developers, testers, business users, trainers, and support representatives.

Main outputs: validated production data, completed UAT, trained users, an approved cutover and rollback plan, and a solution ready for controlled release.

Step 4 – Salesforce hypercare and continuous improvement

The first weeks after launch are usually covered by Salesforce hypercare, a focused period of production support while users adjust to the new platform.

The team monitors integrations, data, automation, and user-reported issues, then resolves high-impact problems quickly. Requests should be recorded and prioritised so that defects, training questions, and future improvements are handled appropriately rather than being placed in a single backlog.

Hypercare should also support user adoption. Clear guidance, accessible documentation, and fast answers help users build confidence in the new processes. Once the platform is stable and issue volumes have fallen, responsibility can move to the regular support and development model.

The next stage is continuous improvement. Stakeholders should review adoption, data quality, open risks, and changing business needs, then agree which enhancements should be delivered next. Release readiness should also become part of regular platform management.

Some organisations manage this work internally. Others use Salesforce managed services to provide structured support, maintenance, and planned improvements.

Typical participants: product owner, Salesforce administrator, support team, business analyst, developers, and representatives from key user groups.

Main outputs: a stable production environment, resolved launch issues, updated documentation, an agreed support model, and a prioritised improvement backlog.

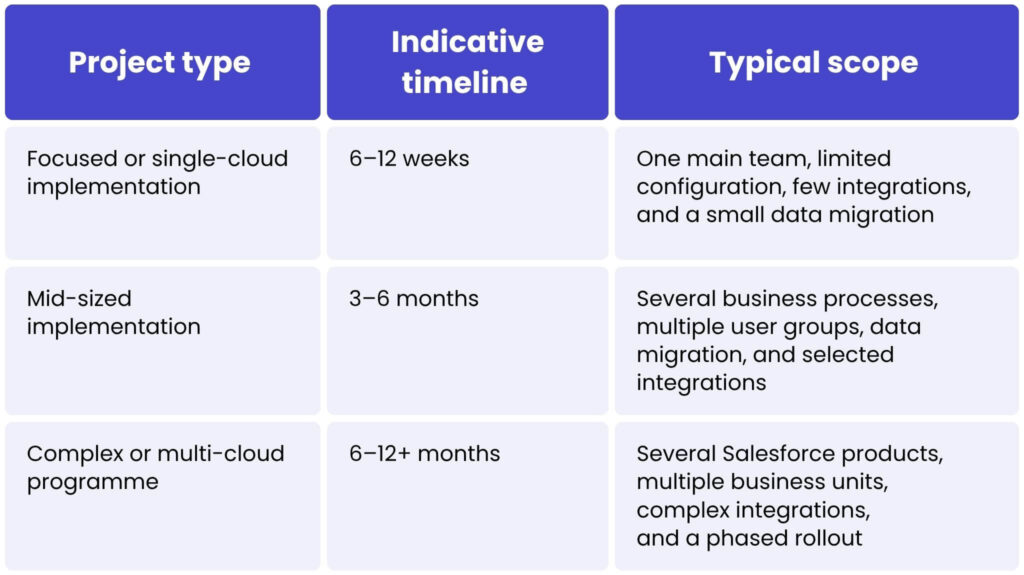

How long does a Salesforce implementation take?

A Salesforce implementation can take from around six weeks for a focused project to more than a year for a complex, phased programme.

How long does a Salesforce implementation take

These ranges are indicative. The timeline depends on scope, customisation, integrations, data quality, security requirements, and the availability of stakeholders for decisions and UAT.

A smaller project can still take longer when requirements are unclear, or when legacy data needs significant preparation. A larger programme may move more efficiently when ownership, governance, and priorities are agreed early.

Discovery helps produce a more reliable estimate by identifying dependencies and delivery risks before the build begins.

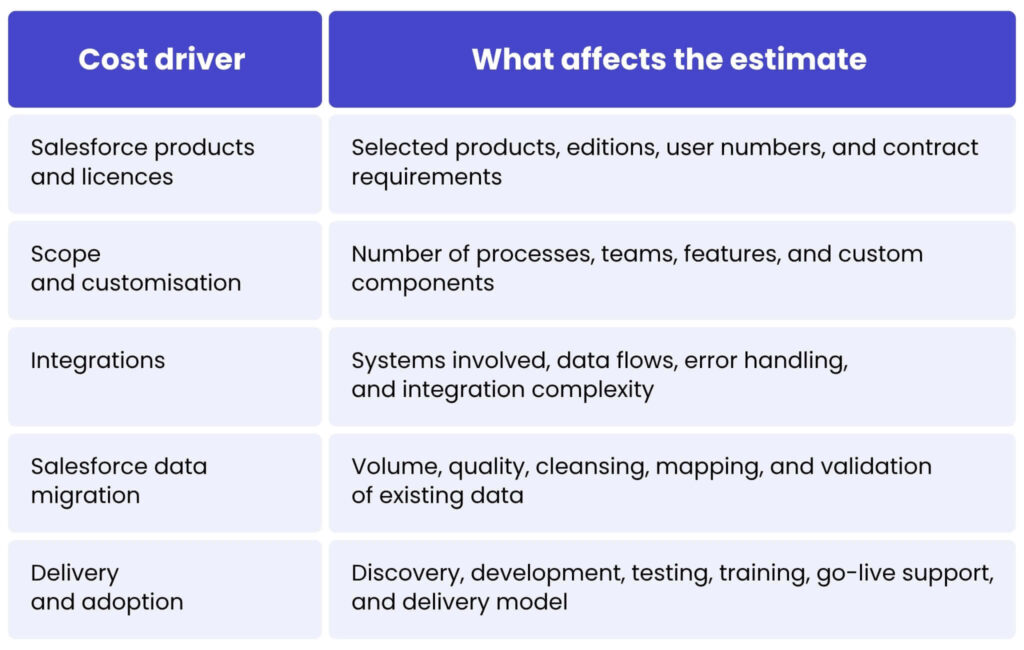

What affects Salesforce implementation cost?

There is no universal Salesforce implementation cost. The total amount depends on the scale of the solution, the condition of the existing systems and data, and the level of business change required.

What affects Salesforce implementation cost

Standard configuration usually requires less effort than extensive custom development. However, even a focused project can become more expensive when legacy data needs significant preparation, integrations are poorly documented, or stakeholder decisions are delayed.

A credible estimate should cover the full implementation lifecycle, not only licences and development. Discovery helps confirm the scope, assumptions, dependencies, and risks before the final budget is agreed upon.

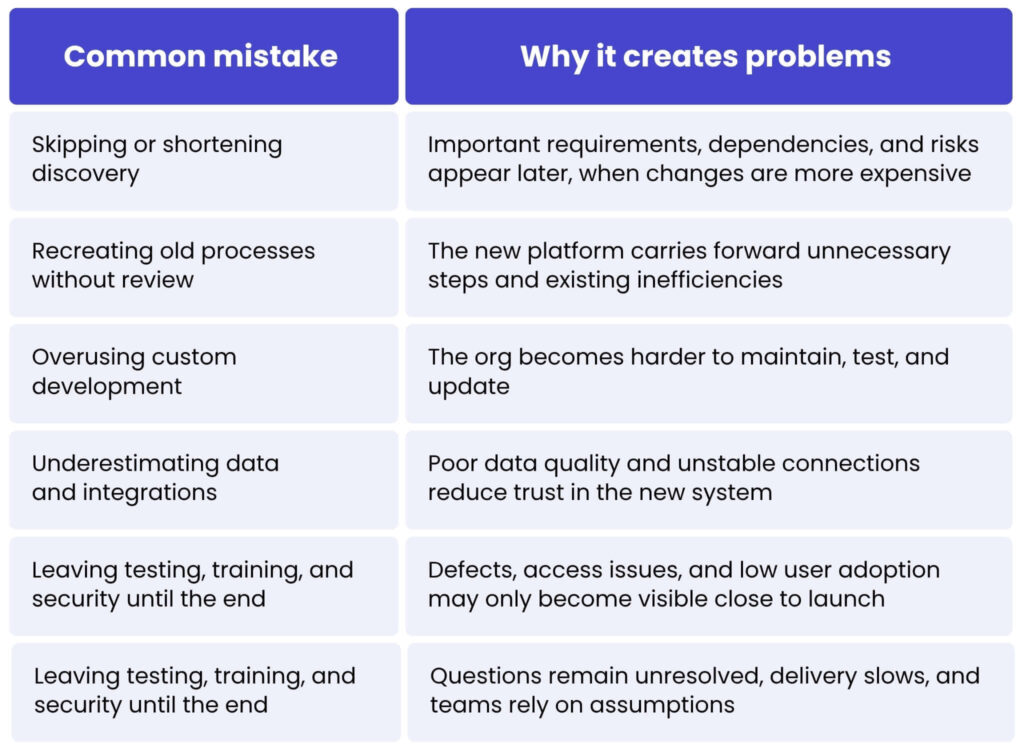

Common Salesforce implementation mistakes to avoid

Salesforce projects rarely fail because of one technical decision. Problems usually build up from several avoidable choices made during planning, delivery, and launch.

Common Salesforce implementation mistakes to avoid

A clear Salesforce implementation plan should address these risks from the beginning. Strong governance, regular stakeholder feedback, and controlled releases are often as important as the technical design itself.

Do you need a Salesforce implementation partner?

Not every project requires a Salesforce implementation partner. An experienced internal team may be able to successfully deliver a focused implementation.

External support becomes more valuable when Salesforce is new to the organisation, the solution includes complex integrations or several products, internal capacity is limited, or independent architecture and delivery oversight are needed.

A strong partner should provide more than additional developers. It should help challenge requirements, explain technical trade-offs, establish delivery standards, and transfer knowledge to the internal team. The goal is to leave the organisation with a maintainable platform and clear ownership after the initial project ends.

When several internal teams or suppliers share responsibility, governance becomes especially important. Our guide to multivendor Salesforce delivery explains how to define responsibilities and reduce gaps between delivery teams.

The right approach depends on project complexity, internal expertise, available capacity, and delivery risk. Explore our Salesforce services to see how Spyrosoft can support implementation planning, delivery, and ongoing platform development.

Final thoughts

A successful Salesforce implementation is not measured only by whether the platform launches on time. It should also support real business processes, provide reliable data, and remain manageable as requirements change.

That requires clear discovery, controlled delivery, careful data migration, realistic testing, and continued support after go-live. When these elements are planned together, Salesforce can become a trusted foundation for daily work and future growth.

The goal is not simply to deploy the platform, but to create an org that people can use with confidence and improve over time.

FAQ

A Salesforce implementation is a process of planning, configuring, integrating, testing, and launching Salesforce for an organisation. It also covers data migration, security, user training, and post-launch support. The objective is to create a platform that supports real business processes and remains manageable as requirements change.

A Salesforce implementation may take 6–12 weeks for a focused, single-cloud project, 3–6 months for a mid-sized implementation, and 6–12 months or longer for a complex programme. The timeline depends mainly on scope, integrations, data quality, stakeholder availability, testing, and organisational readiness.

There is no universal Salesforce implementation cost. The total amount depends on licences, scope, customisation, integrations, data migration, testing, training, and the delivery model. A reliable estimate normally requires a discovery phase to confirm requirements, dependencies, assumptions, and delivery risks before the final budget is agreed.

A Salesforce implementation partner is most useful when Salesforce is new to the organisation, the project includes several products or complex integrations, internal capacity is limited, or independent architecture and delivery oversight are needed. The partner should also transfer knowledge and help establish clear long-term ownership.

Salesforce Sales Cloud implementation is the process of configuring, integrating and deploying the Sales Cloud platform to support lead management, account handling and sales workflows. Companies usually begin this process when spreadsheets or legacy tools no longer scale with their sales operations.

Common mistakes include shortening discovery, recreating inefficient processes, overusing custom development, underestimating data and integrations, and leaving testing, security, or training until the end. Unclear ownership can also delay decisions and force delivery teams to rely on assumptions rather than agreed-upon business requirements.

They can start by documenting sales processes, aligning stakeholders and identifying any gaps in data quality. Clarifying roles and responsibilities early helps avoid confusion during the configuration and testing phases.

They can track user adoption, data accuracy, pipeline visibility and the efficiency of sales workflows. A strong implementation leads to clearer forecasting, fewer manual tasks and more reliable insights for decision-making.
